Nutanix Zero-Copy Migration Removes Data Movement. It Doesn’t Remove Migration Risk.

Zero-copy migration removes one of the most time-consuming parts of a VMware migration: moving the data itself. What it does not remove are the identity, dependency, survivability, and verification risks that still determine whether the migration actually succeeds — and conflating the two is how a genuine engineering improvement gets sold as a safety feature it was never built to be.

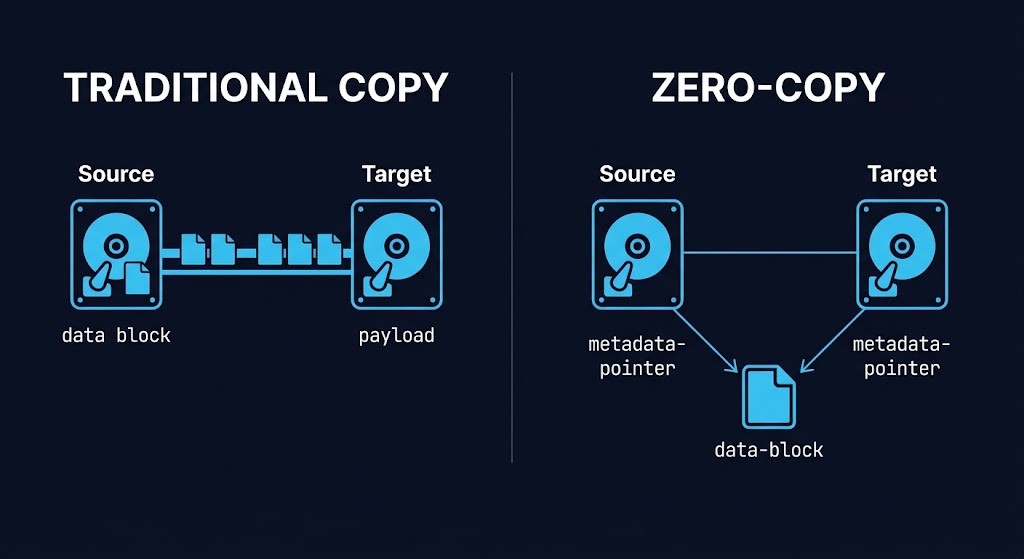

Nutanix Move 6.3, shipped July 29, 2026, added a zero-copy path from ESXi to AHV on supported external storage arrays. Everpure FlashArray was the first array vendor to demo the integration publicly, at Nutanix .NEXT 2026: instead of moving vDisk data across the wire, the array-offload path clones the source vDisks by updating metadata pointers to reference existing data blocks, provisions a new VM mapped to those cloned vDisks, and boots it once the original shuts down. Nutanix’s own framing for this is accurate and worth taking at face value: you’re not moving data, you’re repointing it.
That’s a real capability. It’s also being read by a lot of migration teams as a risk-reduction feature rather than what it actually is — a data-transfer optimization. Those are different claims, and the difference is the entire subject of this post.

What Zero-Copy Migration Actually Improves
Give the mechanism its due before arguing with how it gets sold. Within virtualization architecture, repointing metadata instead of copying blocks removes real, measurable overhead from a migration project: less staging capacity, less temporary storage held during cutover, a smaller maintenance window because there’s no bulk transfer to wait on, less operational effort spent babysitting a copy job, and faster overall execution, especially at the scale where traditional copy-based migration starts to bottleneck on network throughput.
Those are project-efficiency gains — and the mechanism earns one more credit worth naming precisely: because the source VM is preserved rather than consumed, a straightforward rollback exists if something goes wrong with the specific conversion, with no impact to the source environment. That’s a real rollback advantage for the conversion operation itself — a mechanism-native safety property, not a broader recovery guarantee. It is not proof that the migration’s overall risk declined — it’s proof that one specific piece of work, moving bytes from one array to another, got cheaper, faster, and more reversible. Whether the migration as a whole got safer depends on categories of risk that have nothing to do with how the data physically arrived, and that’s the part the “zero-copy” framing quietly skips past.

The Verification Step Hidden Inside Traditional Migrations

Here’s the part of this that’s actually interesting, and it’s not about Nutanix specifically — it applies to any copy-based migration tool. The traditional workflow was never Copy, then Cutover. It was Copy, then Validate, then Compare, then Cutover. Every migration runbook built around that sequence forced a checkpoint that nobody had to design on purpose.
Traditional migration projects rarely added validation because architects loved validation. They added it because moving data forced them to stop and verify that it arrived. A block-level copy operation produces a natural moment to ask three questions: did everything arrive, was it complete, and is the target usable. Checksum comparison, byte-count verification, a boot test against the copied disk — none of that was bolted on as governance. It existed because the copy step made it nearly free to check, and skipping it would have meant shipping a migration nobody had actually confirmed worked.
Zero-copy migration doesn’t skip that check. It removes the event that used to force it. When the workflow is reduced to a conversion event rather than a copy-and-verify event, there’s no longer a natural transfer checkpoint where “did everything arrive?” becomes the obvious next question — because nothing arrived in the sense the old checkpoint was built to catch. Metadata got repointed. The organization can absolutely still build a validation step after a zero-copy conversion. The problem is that nothing about the mechanism requires it, the way the old mechanism incidentally did, and a project plan that just deletes the copy step without consciously rebuilding what the copy step used to force is deleting more than data-transfer time.
Risks That Exist Independent of Transfer Method

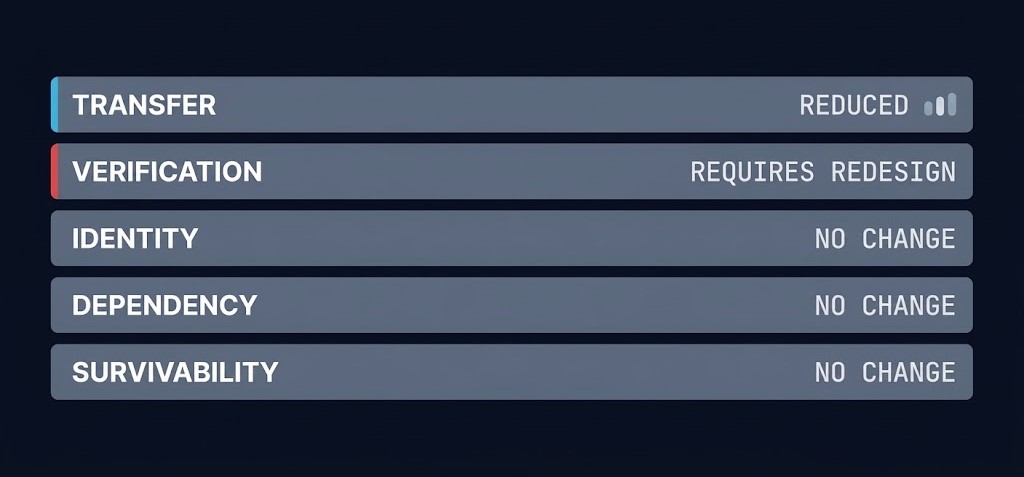

None of what follows is new to this site, and it shouldn’t read as new — that’s the point. These three risk categories were never a function of how the bytes moved, even under traditional copy-based tooling. Zero-copy migration doesn’t make them worse. It also doesn’t touch them at all, which is exactly what gets lost when “we didn’t copy the data” gets heard as “we reduced risk.”
Identity
Machine SIDs, service accounts, SPN registrations, certificate bindings, delegation trusts — Your Migration Succeeded. The Identity Chain Didn’t. already documented six specific ways this breaks, independent of whether the source disk was copied or repointed. Whether those bindings survive cutover depends on which objects the target platform re-creates and how, not on the transfer mechanism that got the disk there.
Dependency
Backup tooling, monitoring agents, automation hooks, DR orchestration — Your VMware Exit Plan Assumed a Tool You Didn’t Control covers what happens when access to a migration-adjacent tool changes mid-project. That risk is about who controls the tools in the plan, not about the method those tools use to move data. A zero-copy path can sit inside a project with exactly this exposure and never touch it. Nutanix Move 6.3.3 adds another ESXi-to-AHV route, DirectPath, which Nutanix describes as not requiring VDDK, but a route that avoids one dependency still needs someone to approve the source-side privileges it requires. Migration Path Authorization: Who Approves the VDDK-Free Route? covers that decision.
Survivability
Rollback capability, recovery execution, fallback operation under real failure — Your VMware Exit Was Successful. The First Incident Will Tell You If That’s True. names this as Framework #145, the Migration Survivability Test: whether the operating model, runbooks, and recovery primitives that matter under failure actually transferred. Zero-copy’s own rollback — reverting a specific conversion by reactivating the preserved source VM — covers a narrower event than #145 does. It answers “did this conversion go wrong,” not “does this platform survive a production incident three months from now using only what actually transferred.” That question is entirely orthogonal to whether the data moved by copy or by metadata pointer. A zero-copy conversion can pass #145’s test or fail it exactly as easily as a traditional one.
Reduced operational effort has a way of reading as reduced risk even when the failure domains underneath haven’t moved. A migration that took a fraction of the time and none of the staging capacity feels safer walking out of the project room — and that feeling is real, it’s just not evidence. The effort went down. The identity chain, the tool dependencies, and the survivability question didn’t get easier because the transfer did.

Scoping Zero-Copy Migration Correctly
The fix isn’t distrusting the mechanism. It’s scoping it correctly in the project plan, which means separating what it earns from what it doesn’t.
TREAT ZERO-COPY MIGRATION AS
- A migration acceleration feature
- A storage-efficiency feature
- A downtime-reduction feature
DO NOT TREAT IT AS
- Identity validation
- Dependency validation
- Recovery validation
This is a line item for VMware migration strategy planning, not an afterthought at cutover: every one of those three risk categories still needs its own independent check, run the same way it would run under a traditional copy-based migration — because the transfer method never had anything to do with closing them. The one deliberate addition zero-copy migration actually requires is smaller than it sounds: rebuild the validation step the copy used to force for free. A boot test, an application-level smoke test, a comparison against pre-migration state — something has to stand in for the checkpoint that disappeared, or the project has quietly traded a slower migration with a built-in verification gate for a faster one with none.
Architect’s Verdict
Zero-copy migration removed the copy. It also removed the verification step that used to come free with it. Nothing else on the risk register moved at all.
That’s not an argument against the mechanism — it’s a legitimate optimization, and the organizations adopting it are making a reasonable call. The argument is against the shortcut in reasoning that turns “the transfer got easier” into “the migration got safer.” Those were never the same claim, and copy-based tooling only ever made them look related because the copy happened to manufacture a validation checkpoint as a side effect of doing its job.
It doesn’t inherit that side effect on its own. If nobody rebuilds it on purpose, the migration isn’t lower-risk. It’s just faster at not knowing.
